Hinkley C second reactor being built 20%-30% faster

Aaron Morby 10 months ago
Share

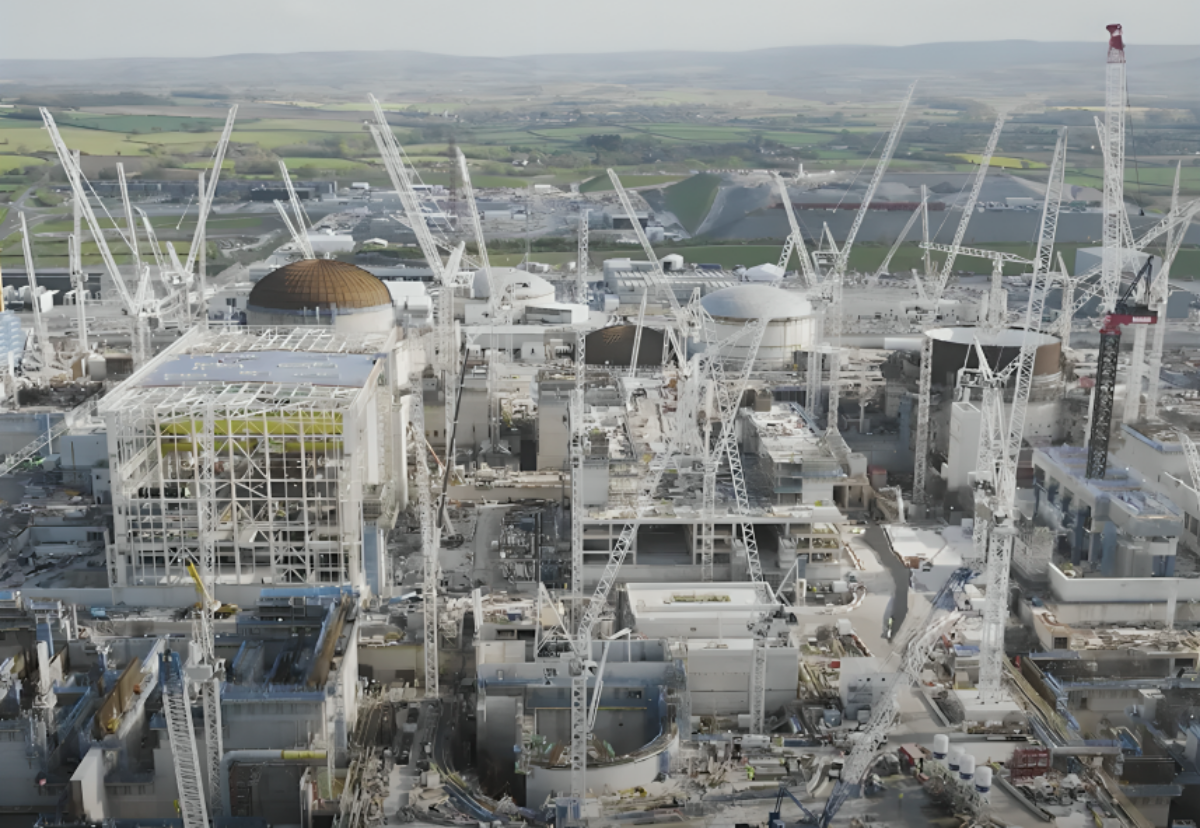

Around 12,000 workers are now driving ahead construction of the Hinkley Point C nuclear power station as preparation work advances to install the first reactor in Unit 1.

Simon Parson, Nuclear Island Area Director, said work was also now accelerating on building second reactor unit buildings where work was typically progressing 20%-30% faster than on unit one.

He said: “It the same job but we are learning better ways to do it.”

Contractors are pioneering a new welding method that is four times faster than the first time around. Modularisation has been increased to carry out more work in factory conditions.

Parson added: “In the reactor two building, the goal is to catch up after we stopped most of the work here during the pandemic.

“The final ring for the reactor 2 unit will be lifted into place later this year, before the dome goes on next year.”

Parson said every innovation at Hinkley was being incoporated into plans for unit three and four at Sizewell C in Suffolk.

So far more than £5bn has been spent with companies across the South West, with 3,800 British businesses supporting the project. Around 8,000 people have received training at the project’s three training Centres of Excellence.

Latest news

Three arrested in Blu-3 and Mace bribery probe

Serious fraud office swoops over alleged £3m bribes to former Mace associates
11 minutes ago

Turkish contractor Limak to build new Luton Town stadium

Construction to start this summer on 25,000-seater venue
8 hours ago

Murphy on board at new £32m rail station

Construction to start next year at Golborne station
7 hours ago

HS2 engineers finish UK’s heaviest bridge slide early

A46 Kenilworth Bypass reopens 30 hours earlier than planned
6 hours ago

Bowmer + Kirkland to build £190m Oxford science scheme

Work to start at end of next month on 180,000 sq ft Fabrica scheme
14 hours ago

New BAM leisure centre pool springs a leak

Contractor investigating "technical issues" delaying new £36m green leisure centre
1 day ago

United Living lands £250m HyNet pipeline deal

Firm wins deal to design and build over 34km of pipework to collect CO2
14 hours ago

Hydrogen diggers get green light to use roads

JCB hails historic decision for advance of hydrogen-fuelled plant on sites
15 hours ago

Go-ahead for McAleer & Rushe Glasgow student job

£100m funding deal paves way for 591-bed student tower
15 hours ago

Fly-tippers to get their vehicles crushed

Drones will be used to identify cowboy construction waste operators
15 hours ago

Green light for £150m West End office revamp

Shaftesbury Avenue office retrofit retains 75% of original building
2 days ago

Morgan Sindall lands £20m Brunswick Wharf scheme in Bideford

North Devon waterside project will provide 100 flats
1 day ago

Former Keltbray managers jailed after corruption trial

Jail sentences following bribery probe on jobs including Battersea Power Station
2 days ago

Lidl pumps £500m into store and logistics expansion

Discounter plans 40 new stores this year as expansion ramps up
2 days ago

JJ Rhatigan UK profit jumps as turnover tops £150m

Irish contractor's expansion in England gathers pace
2 days ago

Driverless digger to be used on Taylor Woodrow site

Autonomous excavator to work at Manchester Airport after successful trial
2 days ago

MCS Build lands Basingstoke warehouse scheme

Construction starts this month after £26m funding deal
2 days ago

Leeds United unveil stadium revamp design

Club has still to set a timeframe for staged Elland Road upgrade
2 days ago

Bowmer & Kirkland boosts margins as profits surge to £69m

Revenue nudges up towards £1.3bn in year of expansion
3 days ago

Offshore construction starts on £4bn windfarm

Foundations for first of 95 turbines installed: Watch video
3 days ago

AECOM buys civils consultant Allen Gordon

Global giant acquires Scottish water and energy specialist
3 days ago

Plans in for £1bn Northern Gateway site in Manchester

Plan for 500-acre manufacturing and logistic park advance
3 days ago

RED wins £31m London Shoreditch student digs job

Two extra floors will be added to Willen House scheme
3 days ago

Deconstruct handed £12m Grenfell demolition

Firm maintaining building awarded job without bid race to speed process
3 days ago

Sizewell site workers get made to measure PPE

Bespoke fitting service on offer at new Bryson branch
3 days ago

Comment: Gateway is acting like a barricade

Contractors left banging their heads on an (unbuilt) brick wall
6 days ago

Final phase of £1.5bn Elephant and Castle revamp hits planning

Get Living submits revised plan for 500 homes and 450-bed student block
6 days ago

Ealing backs final phase of £1.3bn estate rebuild

Friary Park estate rebuild in Acton reaches end stage
6 days ago

Green light for scaled-down Nottingham student tower

Glasshouse Street scheme will deliver 247 student rooms
6 days ago

Aston Villa to revamp North Stand

Club to reuse existing structure rather than complete rebuild
6 days ago

Contractor services
